Explore guide
Estimate thread and time for full coverage
Separate chart area from actual stitched count and time a representative color-changing section.

Related lessons and tools
Separate chart area from actual stitched count and time a representative color-changing section.
Before you start
Have the chart key, chart width and height, fabric thread count and threads crossed by each stitch. Keep floss strands separate from fabric threads.
How to do it
- Read the counted-chart key — A symbol identifies the thread and stitch treatment assigned by that chart. Similar colors or symbols in another chart do not imply the same assignment.
- Track scattered colors — Work from checked landmarks and record completed stitches without hiding unworked symbols. Small color islands need deliberate starts and travel paths.
- Estimate floss from a stitched sample — Measure the thread actually consumed by a known stitch count, including representative starts and finishes. Use matching ground, strands and stitch structure.
- Include assembly and finishing time — Separate active making, active finishing and passive drying time. A percentage buffer cannot represent an overnight drying dependency by itself.
Try this example

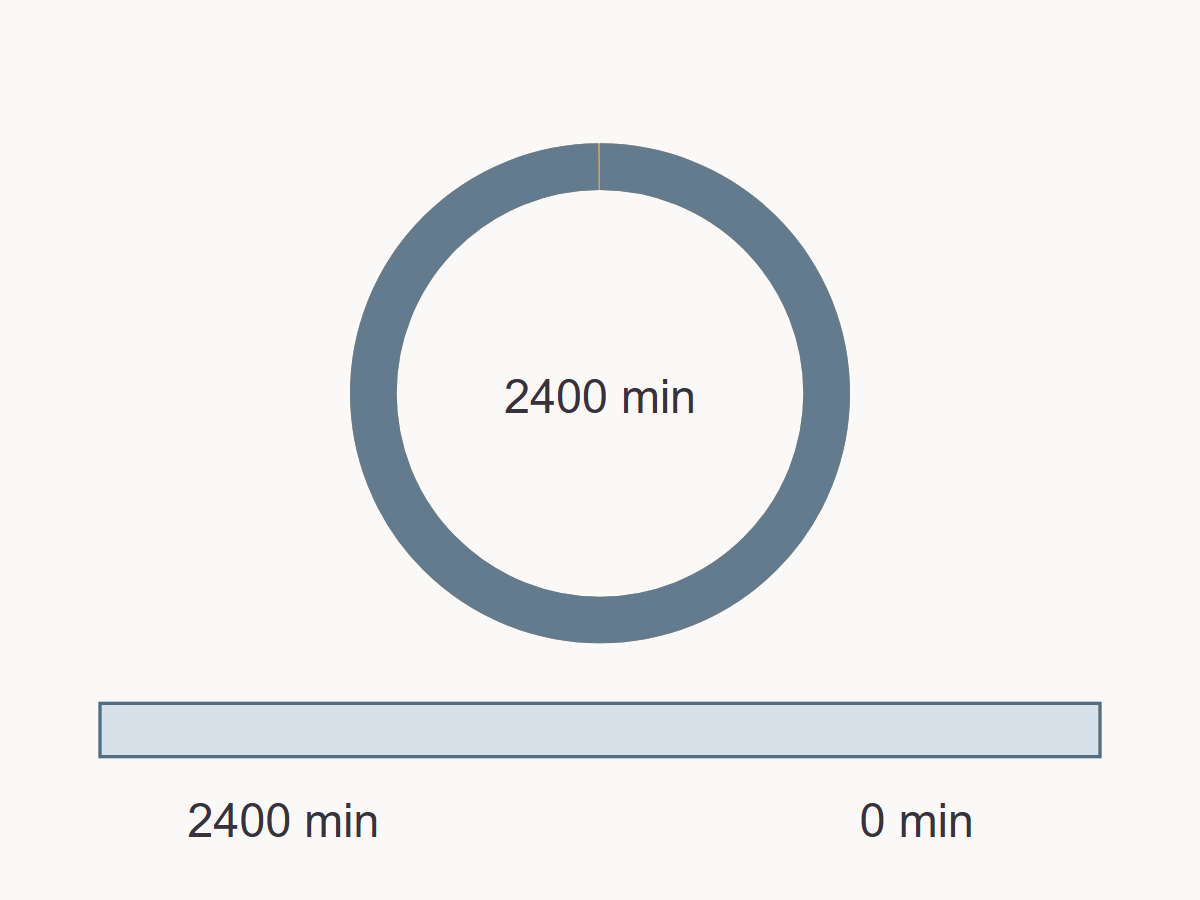

A fully covered 100 × 80 chart contains 8,000 crosses. At a measured 100 crosses per 30 active minutes, the base is 2,400 minutes before extra counting, starts, backstitch and finishing.
Check your result
- Count from two independent reference points before filling a large area. Verify the outer stitched dimensions on the actual ground; include finishing fabric separately.
- Changing fabric count changes physical size, not chart complexity. Fractional stitches, mixed scales and non-square grounds need explicit chart instructions.
Sources

Sampled project-time estimator
Scale a timed sample into a realistic working estimate with your own allowance.
Before you use this tool
Time a representative count of the same units used for the target: stitches, rows or motifs. Include assembly separately if the sample omits it.
Avoid adding breaks twice. The central estimate and range support scheduling; they are not a deadline guarantee or an assessment of skill.
Method and limits
Formula and assumptions
Observed minutes per unit are scaled to the target, selected complexity factor, and break allowance. The result shows a ±15% planning band for ordinary pace variation. Use comparable sample and project units; include breaks in the sample or allowance, but not both.
Worked example
Example: 50 units in 20 minutes, scaled to 500 units plus 15%, gives a 3.3–4.4 hour planning range around a 3.8 hour central estimate.
Limits and rounding
Results are planning estimates from the values entered. Displayed decimals are rounded for craft use; whole materials and repeats round up where the method says so. Confirm gauge, material behavior, construction, and finished measurements before committing supplies.
